Skip to content
Himaad Riaz
All work

01 / 04

AI & COLLABORATION / WEB APP

Work still got lost between tasks, decisions and people.

Decisions made in meetings stayed in someone's notes, and calendar clashes were found by whoever showed up late. Version 6.0 is the redesign.

42 screensdesigned for version 6.0

Role
UX Designer & Researcher
Timeline
Version 6.0
Platform
Web app, desktop
Tools
Figma

01 / 09

The product is a project management web app with an AI assistant that reads the board and flags risk, like tasks likely to slip, uneven workloads and columns filling up. The first version put that assistant inside the Kanban board so teams could stop chasing status.

6.0 started with one question: where does work still slip once the board is set up? Two places stood out. Meetings, where decisions get made and then live in someone's head. And the calendar, where a conflict usually gets found by the person who shows up late. The redesign is built around closing those two gaps without making the product any louder.

The role: the Focus rules, interaction and visual design for every 6.0 screen, the component updates behind them, and the developer handoff.

42
screens designed for 6.0
6
product areas, from Projects to Meeting AI
2
flows designed end to end, from first click to result
51
open questions logged for engineering instead of guessed

The board, with AI Insight open

The calmer board with its one AI entry point open beside it: what needs attention, and what to do about it. The work underneath keeps its space.
The 6.0 board in Kanban view with the AI Insight panel open on the right: progress by status, three items that need attention and suggested next steps.

Figtree, and nothing else

One family carries the whole product, from page titles to the smallest chip. Weight does the work colour used to.

Aa

Figtree

Website Launch

Review suggestions

In 2 days · UI/UX Design

Colour only where it means something

Blue for the main action, violet for anything the AI did, and one colour per priority. Everything else stays neutral.
  • Primary#0B57D0
  • AI#7F5DF6
  • High#C5221F
  • Medium#B06000
  • Low#137333
  • Canvas#EFF3FB

02 / 09

The first version fixed status chasing on the board. Looking at the product as it stood in 5.0, the problems that were left sat around the board, plus some noise on it.

  • Meetings ended, and the decisions stayed there: Action items lived in someone's notes. Owners were implied, dates were vague, and turning any of it into tasks was a manual job after the call.
  • Conflicts showed up at the last minute: Booking a meeting meant checking other people's calendars by eye. Overlaps were found when someone arrived late, and focus time was the first thing to get run over.
  • The board said everything, everywhere: Every card carried a comment count and a priority word, some carried an AI sentence too, and AI showed up in more than one place on the same screen.
  • Controls repeated themselves: The calendar offered filtering and sorting in two places, so people had to guess which one was in charge.

03 / 09

Making

Before any layout changed, a short set of Focus rules came first. Every 6.0 screen follows them, and they are what keep 42 screens feeling like one product.

When a screen started to get busy, the rules were the first check. Most of the cleanup in 6.0 is a rule applied, not a one-off fix.

  • Two header rows on every work screen: The title row holds the project and its actions. The view row holds the view switch plus only the controls that view needs.
  • One AI entry point per screen: AI sentences live in the AI panel. Cards carry a small At risk chip, nothing more.
  • Cards answer who, what and when: ID and people, a title of two lines at most, then a priority meter, due date and label. No comment counts, no priority words.
  • Colour only where it means something: Each priority level has its own colour: High red, Medium amber, Low green. Beyond that, only overdue, AI and meeting category get colour.
  • AI suggests, people decide: Every AI action ends with a choice, and the copy says so: nothing changes until you pick one.
  • Side panels make room: Opening a panel switches the header to its narrow version, so the work underneath keeps its space.

Before · 5.0

The 5.0 board: AI in the header, in a summary strip and on a card, and every card carrying a comment count and a coloured priority word.
AI shows up in the header, in a summary strip and on a card. Every card carries a comment count and a coloured priority word.

After · 6.0

The 6.0 board: one AI Insight button, three-row cards and a small priority meter in place of the word.
One AI Insight button. Cards drop to three rows, and a small meter coloured by level replaces the priority word.

04 / 09

Making

Meetings are where a lot of decisions happen, and the worst place to keep them. Action items end up in a doc nobody opens, owners are implied, and the follow-up depends on whoever remembers.

If a decision never becomes a task, the board is wrong from the start, and every AI insight built on top of it is wrong too. Getting meetings into the board is what makes the rest of the product worth trusting.

The result: the person who ran the meeting reviews a draft instead of writing one, and the board reflects what was actually agreed.

  • Take Notes: Start from the meeting pill, the week view or the day panel.
  • Consent: Everyone agrees before anything is captured.
  • Live notes: Summary, decisions and action items build as people talk.
  • Report: A private draft with a timestamp on every line.
  • Review: Fix owners and dates, then create only what is checked.
  • On the calendar: Tasks land on their due days, linked to the notes.

Consent comes first, and it is specific

Nothing is captured until everyone agrees, and the dialog says exactly what is kept. Audio is off by default and deleted once the transcript is ready.

Notes you can check against the source

The report opens as a private draft. Every summary line, decision and action item carries a timestamp from the call.

Suggestions stay suggestions until reviewed

A task without an owner blocks Create Selected, and the footer says why. Add the owner and it can be created.

Every task knows where it came from

Tasks from the notes land on their due days with a From link back to the meeting they were agreed in.

05 / 09

Making

Scheduling across a team meant opening calendars and comparing them by eye. Conflicts got found when someone showed up late, and focus time was usually the first thing to give.

A booked conflict costs everyone in it. Catching it while the event is still a draft costs almost nothing, as long as the check is quick and honest about what it looked at.

The result: conflicts get handled while they are cheap to fix, and people still make the final call.

  • New event: Pick a title, time and people in the new-event dialog.
  • Overlap hint: The dialog flags an overlap as soon as it exists.
  • Overlap check: Every conflict sits on one small timeline.
  • Open times: Pick a time that works, or Book Anyway.

Warn while it is still a draft

The new-event dialog checks the time as you set it and flags an overlap inline. When nothing clashes, there is no extra step at all.

Show the conflict, then the way out

The clash sits on one small timeline, then open times that work for everyone, each leading with the time and why it was picked.

Focus time can bend. Meetings can't.

When the clash is your own focus time, the suggestion splits the block instead of moving the meeting, and says how much focus you keep.

Honest about what it checked

Every suggestion names its basis. When no time works for everyone it says so plainly, and Book Anyway is always there.

The week, looked at afterwards

Insights shows where the week went, by category and by hour, with suggestions like protecting focus time. Suggestions stay suggestions.
Calendar Insights for the week: 11h 45m in meetings, time by category in stacked bars, a heat map of meetings by hour, and three suggestions from the assistant.

06 / 09

Making

The two features carry the story, but most of 6.0 is the same Focus rules applied screen by screen. These are the changes worth looking at first.

One place for what needs attention

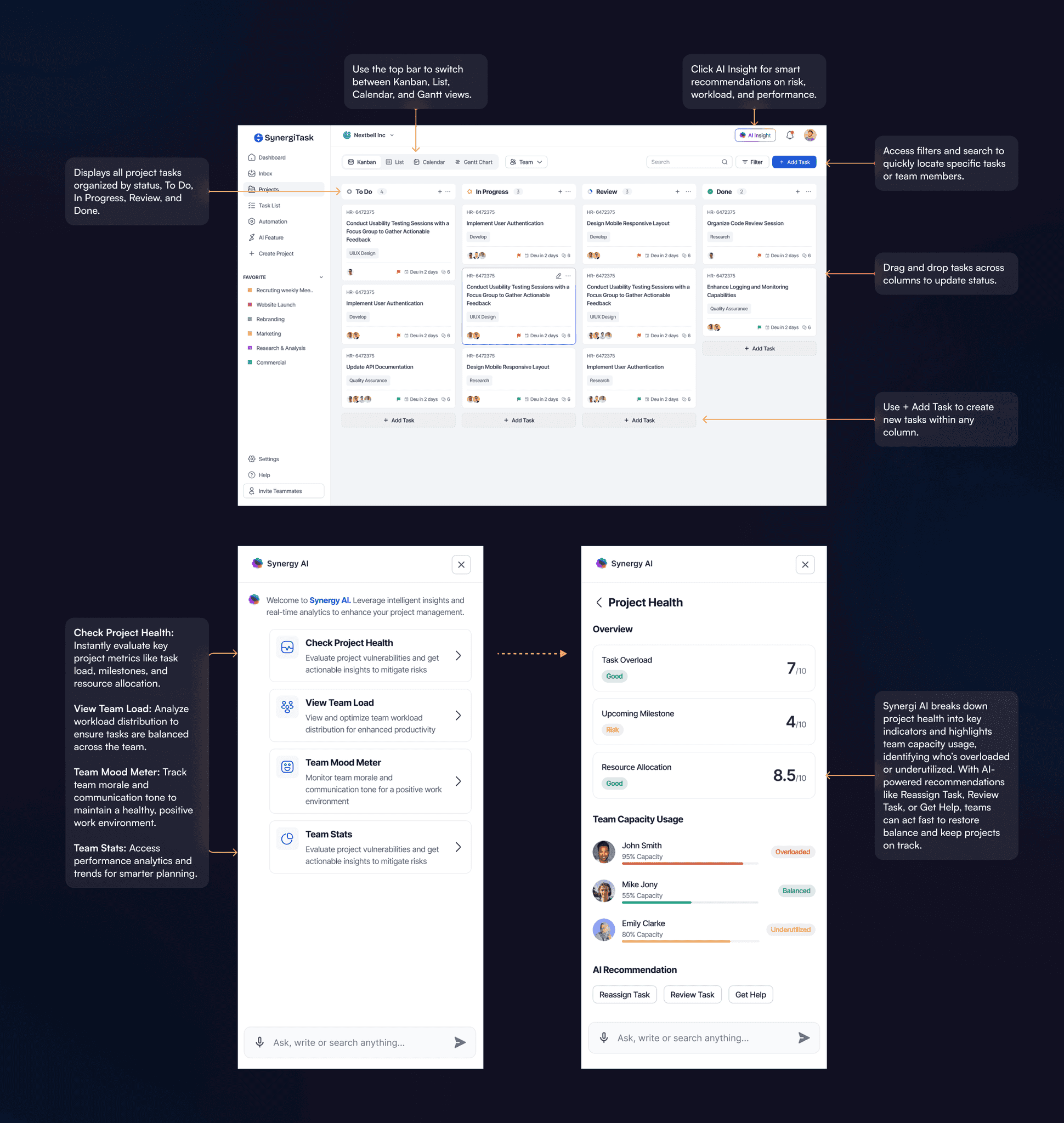

The AI Insight panel replaces AI lines scattered across the board. It leads with what needs attention and suggests next steps.

Project health, with its reasons

Asked how a project is doing, the assistant scores the milestone, task load and people, each with the reason in plain words.

Automations you can describe in a sentence

The rule builder reads every rule back as a sentence. Describe what should happen and the steps are drafted on the canvas for you to keep or not.
The rule builder: a rule read back as a sentence beside its steps on the canvas.

Filter for what you see. The view menu for how.

Filtering and sorting used to live in two places. Quick filters now sit in Filter; layout choices like weekends and week numbers sit in the view menu.
The Filter menu: Assigned to me, Due soon and High priority quick filters, then label, status, priority and assignee.The view menu: Day, Week or Month, what to show, weekends and week numbers.

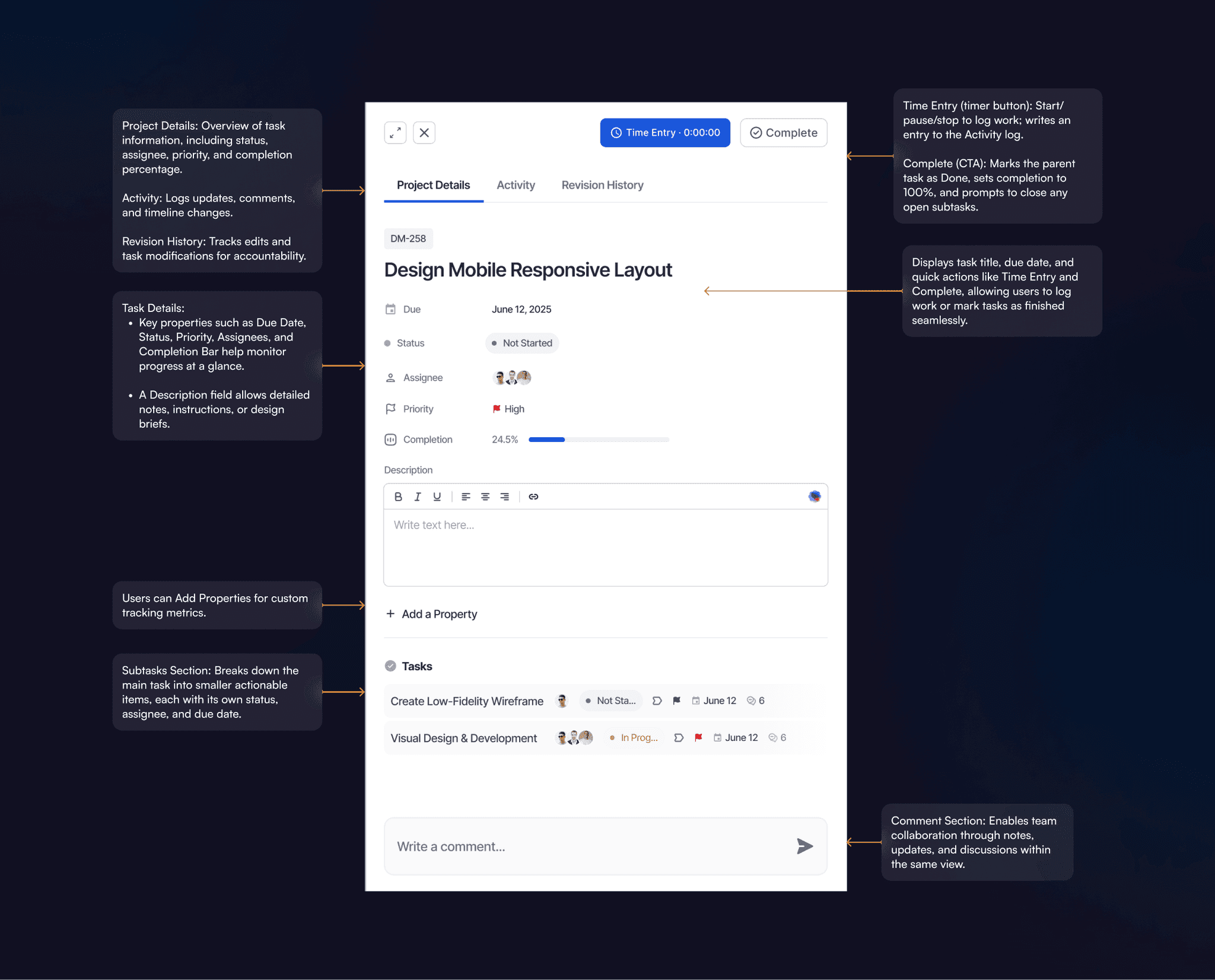

A card that answers who, what and when

Three rows, no comment counts, no priority words. A small meter coloured by level does that job, and At risk appears only when a task needs it.

07 / 09

Making

Every screen below is from 6.0.

The 6.0 board in Kanban view with To Do, In Progress and Review columns and a single AI Insight button.

The board

Two header rows, one AI entry point and three-row cards. The rest of 6.0 follows from these rules.

The project in List view: tasks grouped under To Do, In Progress and Review with assignee, label, priority and due date columns.

List

The same tasks grouped by status, with owner, label and due date in columns that line up.

My Tasks: tasks from several projects in one list, grouped by project, with status, priority and due date.

My Tasks

Everything assigned to you across projects, sorted by when it is due.

A task opened full screen: title, description, subtasks and attachments, with status, assignees, dates and time tracking beside them.

A task, full screen

Description, subtasks, linked tasks and files on the left; the details and activity on the right.

The board with the assistant open on the right, answering how healthy the project is with a project health score and a suggested plan.

Asking about project health

The assistant answers in the side panel while the board keeps its space beside it.

The calendar in Month view: tasks and meetings across April, one marked overdue.

The month

Tasks and meetings on the days they land, overdue work marked where it sits.

The calendar in Week view with a pill in the header for the Checkout redesign review starting in 15 minutes and a Take Notes button.

The week, before a meeting

A meeting about to start shows in the header with Take Notes one click away.

A video call with a shared payment screen, and on the right the live notes panel building a summary, a decision and two action items.

Notes during the call

The summary, decisions and action items build in a panel beside the call as people talk.

The call while someone presents, with the notes panel showing the snapshots kept so far.

Screen snapshots

When someone presents, the notes ask again before keeping any snapshots of the shared screen.

The overlap check for an event that clashes with three others, each listed with how much it overlaps, then one open time.

Overlapping three events

Every clash on one timeline, then the open times that work for everyone.

The calendar with a day panel open on the right listing that day's meetings and tasks.

A day, in a side panel

Click a day for its meetings and tasks, with Take Notes on the meeting that is coming up.

The new project dialog on its first step: name, icon colour, visibility and an option to draft starter tasks.

Starting a project

Three short steps: details, the default view, and who is in it.

The calendar with its view menu open: Day, Week and Month, plus toggles for weekends and week numbers.

The view menu

Day, week or month, and what to show, all in one menu.

08 / 09

Outcome

There are no numbers for 6.0 to report yet. The figures below are from the first launch, as published in the original case study. They describe the earlier product, not 6.0.

  • Meeting suggestions: how many get created versus dismissed, and how often owners or dates get fixed first.
  • Time to the board: how long it takes from the end of a meeting to tasks on the board.
  • The overlap check: how often it ends in a different time instead of Book Anyway.
  • The AI Insight panel: whether people open it more once AI stops appearing on every card.

+78%
daily active users after the first launch, from 2.1k
−43%
project completion time after the first launch, from a 14-day average
+125%
cross-team interactions after the first launch, from 320 a month
4.7 / 5
customer satisfaction after the first launch, up from 3.2 across 1,250 reviews
92%
feature adoption after the first launch, up from 34%

09 / 09

  • Rules scale better than screens: Writing the Focus rules first made it easier to say no. Most of the cleanup in 6.0 came from applying a rule, not from redesigning a screen.
  • Show the basis, then ask: an AI feature should show what it looked at and wait for a decision, not act and apologize. Every AI surface in 6.0 works that way.
  • The edges took the most thought: Consent, a task with no owner, a week where no time works for everyone. The screens nobody screenshots were the hardest ones to get right.
  • Handoff keeps you honest: Writing the developer handoff surfaced 51 open questions, from consent for late joiners to what Undo should do on AI notes. They're listed for the team instead of papered over.

Keep reading
